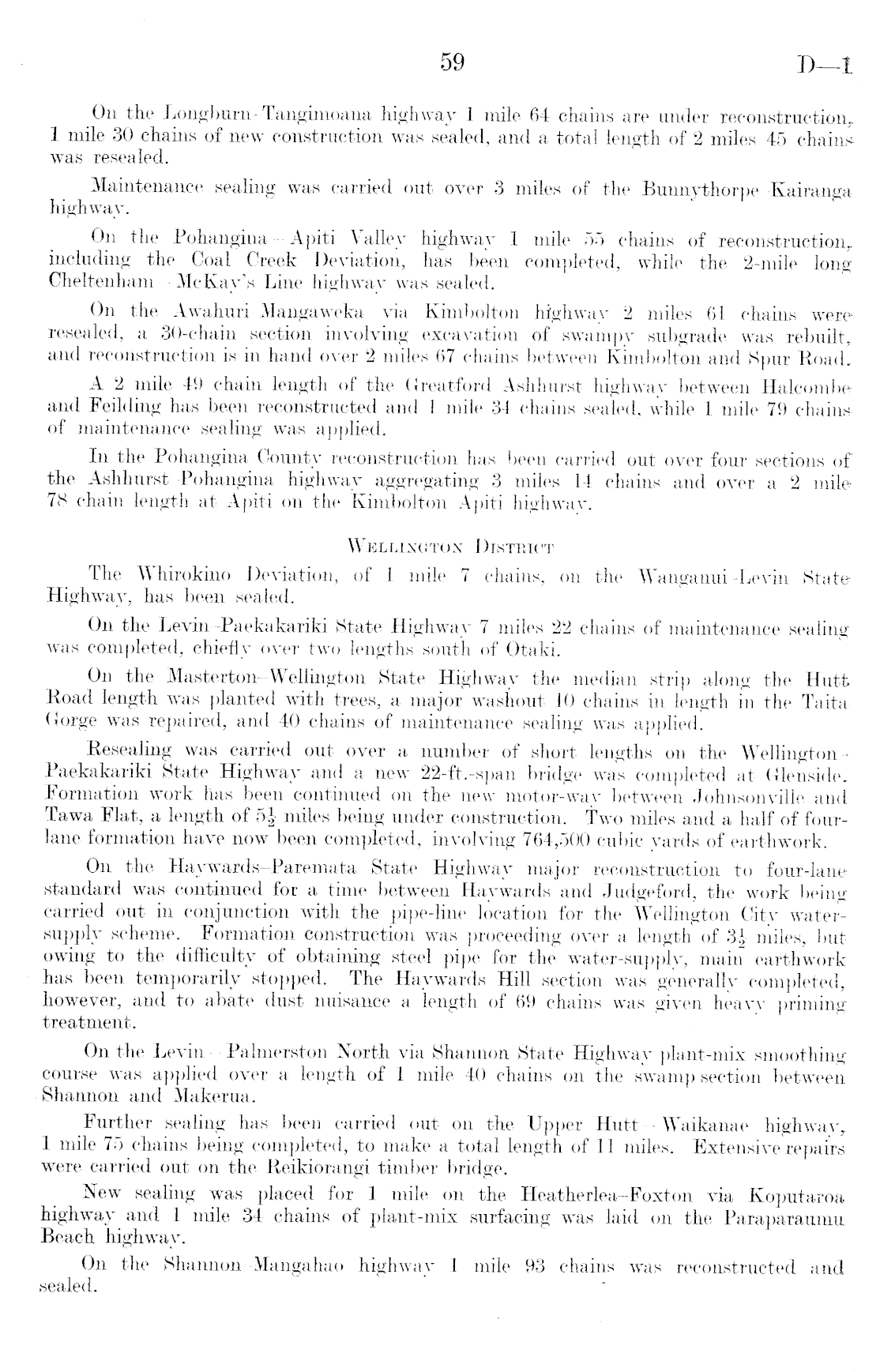

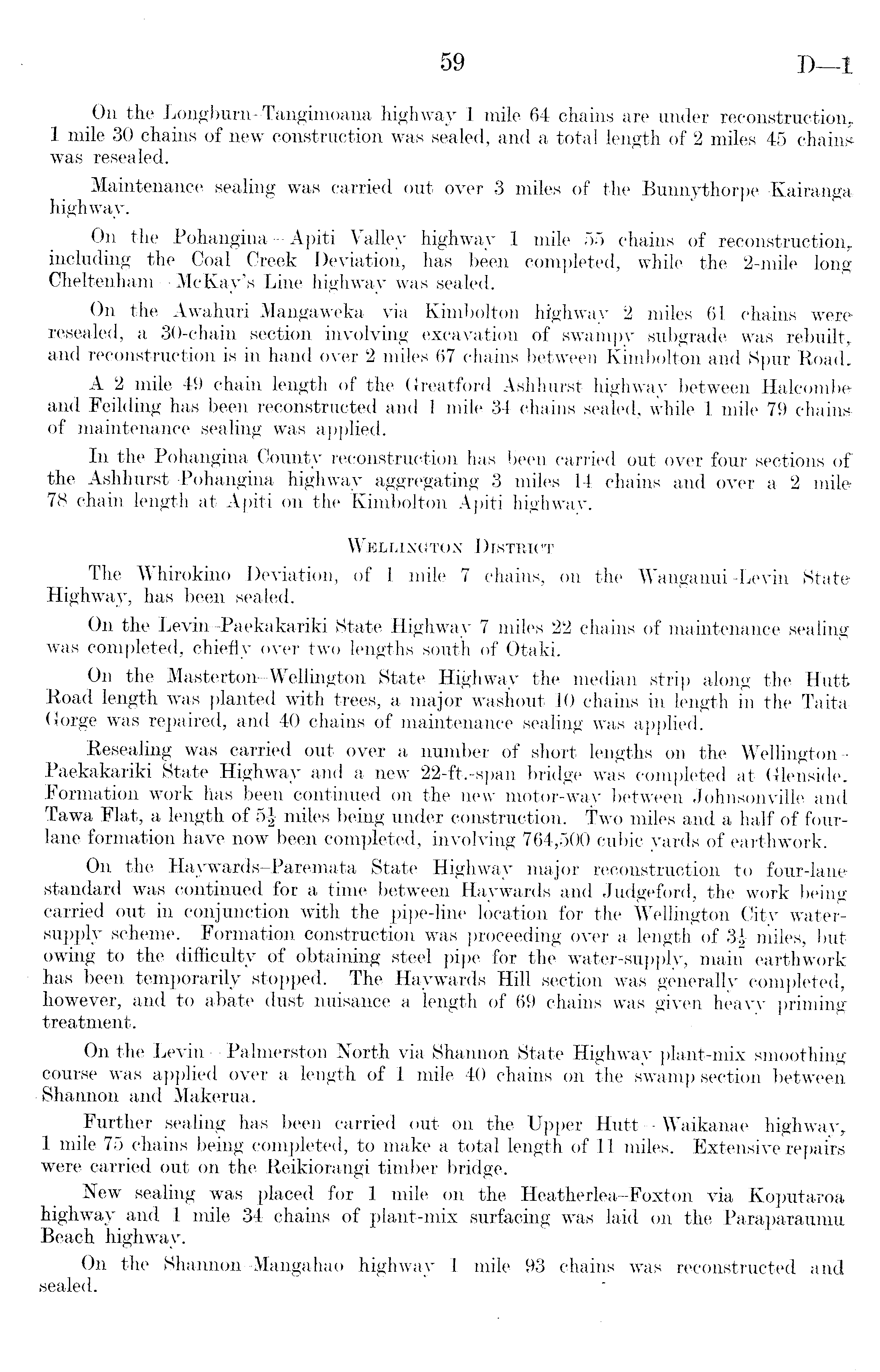

D—l
On the Longburn-Tangimoana highway 1 mile 64 chains are under reconstruction, 1 mile 30 chains of new construction was sealed, and a total length of 2 miles 45 chains was resealed. Maintenance sealing was carried out over 3 miles of the Bunnythorpe-Kairanga highway. On the Pohangina - Apiti Valley highway 1 mile 55 chains of reconstruction, including the Coal Creek Deviation, has been completed, while the 2-mile long Cheltenham - McKay's Line highway was sealed. On the Awahuri-Mangaweka via Kimbolton highway 2 miles 61 chains were resealed, a 30-chain section involving excavation of swampy subgrade was rebuilt, and reconstruction is in hand over 2 miles 67 chains between Kimbolton and Spur Road, A 2 mile 49 chain length of the Greatford-Ashhurst highway between Halcombe and Feilding has been reconstructed and 1 mile 34 chains sealed, while 1 mile 79 chains of maintenance sealing was applied. In the Pohangina County reconstruction has been carried out over four sections of the Ashhurst-Pohangina highway aggregating 3 miles. 14 chains and over a 2 mile 78 chain length at Apiti on the Kimbolton-Apiti highwav. Wellington District The Whirokino Deviation, of 1 mile 7 chains, on the Wanganui-Levin State Highway, has been sealed. On the Levin-Paekakariki State Highway 7 miles 22 chains of maintenance sealing was completed, chiefly over two lengths south of Otaki. On the Masterton-Wellington State Highway the median strip along the Hutt Road length was planted with trees, a major washout 10 chains in length in the Taita Gorge was repaired, and 40 chains of maintenance sealing was applied. Reselling was carried out over a number of short lengths on the Wellington - Paekakariki State Highway and a new 22-ft.-span bridge was completed at Glenside. Formation work has been continued on the new motor-way between Johnsonville and Tawa Flat, a length of 5£ miles being under construction. Two miles and a half of fourlane formation have now been completed, involving 764,500 cubic yards of earthwork. On the Haywards-Paremata State Highway major reconstruction to four-lane standard was continued for a time between Haywards and Judgeford, the work being carried out in conjunction with the pipe-line location for the Wellington Citv watersupply scheme. Formation construction was proceeding over a length of 3£ miles, but owing to the difficulty of obtaining steel pipe for the water-supply, main earthwork has been temporarily stopped. The Haywards Hill section was generally completed, however, and to abate dust nuisance a length of 69 chains was given heavy priming treatment. On the Levin - Palmerston North via Shannon State Highway plant-mix smoothing course was applied over a length of 1 mile 40 chains on the swamp section between v Shannon and Makerua. Further sealing has been carried out on the Upper Hutt - Waikanae highway, 1 mile 75 chains being completed, to make a total length of 11 miles. Extensive repairs were carried out on the Reikiorangi timber bridge. New sealing was placed for 1 mile on the Heatherlea-Foxton via Koputaroa highway and 1 mile 34 chains of plant-mix surfacing was laid on the Paraparaumu Beach highway. On the Shannon-Mangahao highway 1 mile 93 chains was reconstructed and sealed.
59
Use your Papers Past website account to correct newspaper text.
By creating and using this account you agree to our terms of use.
Your session has expired.
